Moving from VMware to Sangfor HCI: What Changes After Migration?

Moving from VMware to Sangfor HCI changes how your IT team manages VMs, handles capacity, deals with issues, and runs backup and disaster recovery.

If you’re considering a VMware alternative because of Broadcom’s licensing changes, the license price is only one part of the decision. This guide looks at what happens after migration, from VMware compatibility and day-to-day management to renewals, support, performance, backup, and recovery.

TL; DR

Is Sangfor HCI Compatible with Your Existing VMware Setup?

The infrastructure layer changes. The workloads sitting on top of it mostly don’t.

A typical VMware environment has a few different pieces working together: ESXi for virtualization, vSAN for storage, and NSX for networking. With Sangfor HCI, those functions are brought together into one stack. aSV takes over the hypervisor role, aSAN handles storage, aNET handles networking, and aSEC provides built-in security.

That sounds like a big platform change. For the workloads, though, it usually isn’t.

Your VMs don’t need to be rebuilt just because the underlying hypervisor changes. Applications don’t suddenly need to be reconfigured to work on Sangfor. The goal is to move the workloads while changing the infrastructure underneath them.

What stays the same:

  • VM structure and configuration
  • Application compatibility
  • Existing data, migrated without loss

What changes:

  • The hypervisor, from ESXi to aSV
  • The management layer, from vCenter workflows to Sangfor’s unified console
  • How storage and networking are managed

The migration itself typically happens in three stages.

First, the existing environment is assessed and workloads are mapped so you know exactly what needs to move and in what order.

Then comes the migration. Instead of treating it as one big switch-over, workloads can be moved in a planned sequence to keep disruption to a minimum.

Finally, the part that often gets overlooked: ongoing management. With a Gold Partner-managed migration, the environment can move into ongoing AMC support rather than leaving your IT team to manage a completely new platform on their own.

How Does Day-to-Day Management Change After Migration?

The honest answer is that not much of the admin’s day-to-day work changes. Provisioning a VM is still provisioning a VM.

What changes is what happens when something looks wrong and you need to figure out why.

In a split VMware stack, a storage alert doesn’t necessarily mean the storage is the problem. The root cause could be a network bottleneck or a compute resource issue somewhere else in the stack. Finding that connection often means jumping between consoles and comparing timestamps to work out whether the events are related.

With Sangfor HCI, compute, storage, networking, and security are managed through a unified layer. That gives admins a single view of the environment, making it easier to trace an issue back to its source without moving between multiple management tools.

That may sound like a small change. In practice, it can be the difference between quickly checking what happened and having a ticket sit open while someone works out which system or team owns the problem.

The bigger adjustment is familiarity. An admin who has spent years working in vCenter knows where everything is almost without thinking. Moving to a new interface means rebuilding that muscle memory. The underlying concepts haven’t changed — VMs, resource allocation, networking, segmentation – but the way you access and manage them has.

So there is a learning curve. But you’re learning a new management experience, not relearning infrastructure from scratch.

A dedicated migration and support partner can also shorten that learning curve by helping your team with troubleshooting, platform administration, and the transition to the new environment.

What Happens to Licensing and Renewals Going Forward?

Broadcom didn’t just change VMware’s price. It changed who could sell and support it.

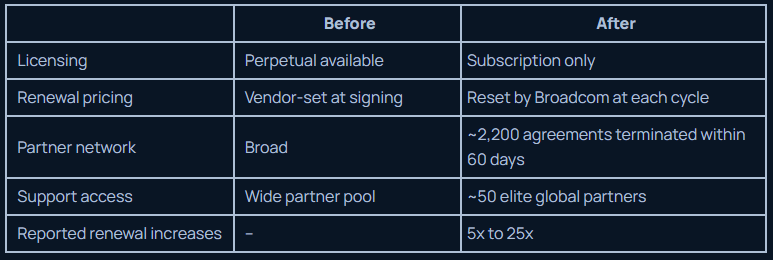

Before
After
Licensing
Perpetual available
Subscription only
Renewal pricing
Vendor-set at signing
Reset by Broadcom at each cycle
Partner network
Broad
~2,200 agreements terminated within 60 days
Support access
Wide partner pool
~50 elite global partners
Reported renewal increases
5x to 25x

Sangfor isn’t necessarily cheaper. But its pricing is more predictable. And after dealing with repeated Broadcom renewal increases, that predictability can matter just as much as the price itself.

Comparing license prices alone can make the migration look cheaper or more expensive than it really is. Look at the full cost of owning and supporting the environment over the period you actually plan to run it.

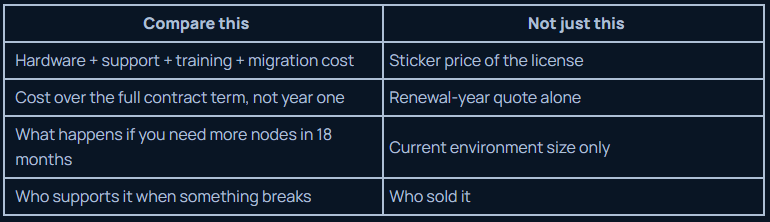

Compare this
Not just this
Hardware + support + training + migration cost
Sticker price of the license
Cost over the full contract term, not year one
Renewal-year quote alone
What happens if you need more nodes in 18 months
Current environment size only
Who supports it when something breaks
Who sold it

None of that shows up in a licensing quote. It shows up in the validation you do before you sign anything.

What Should You Validate Before Migrating from VMware to Sangfor HCI?

Planning the migration is relatively straightforward. What usually gets skipped is confirming the environment actually behaves the way you expect once the workloads are on the other side.

Test the parts that could cause problems after the move.

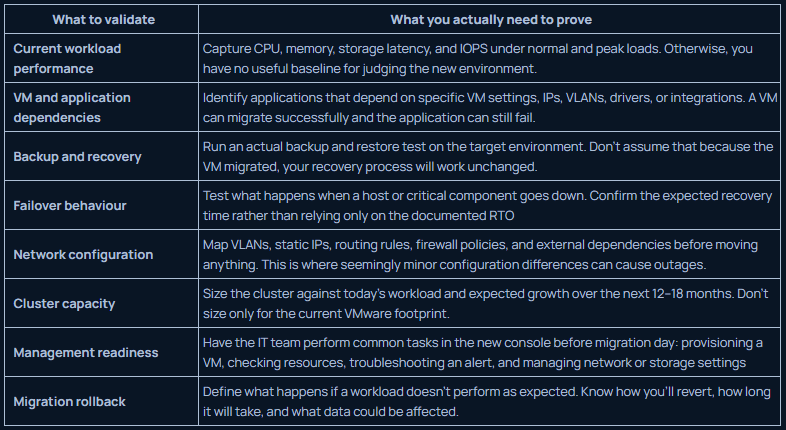

What to validate
What you actually need to prove
Current workload performance
Capture CPU, memory, storage latency, and IOPS under normal and peak loads. Otherwise, you have no useful baseline for judging the new environment.
VM and application dependencies
Identify applications that depend on specific VM settings, IPs, VLANs, drivers, or integrations. A VM can migrate successfully and the application can still fail.
Backup and recovery
Run an actual backup and restore test on the target environment. Don’t assume that because the VM migrated, your recovery process will work unchanged.
Failover behaviour
Test what happens when a host or critical component goes down. Confirm the expected recovery time rather than relying only on the documented RTO
Network configuration
Map VLANs, static IPs, routing rules, firewall policies, and external dependencies before moving anything. This is where seemingly minor configuration differences can cause outages.
Cluster capacity
Size the cluster against today’s workload and expected growth over the next 12–18 months. Don’t size only for the current VMware footprint.
Management readiness
Have the IT team perform common tasks in the new console before migration day: provisioning a VM, checking resources, troubleshooting an alert, and managing network or storage settings
Migration rollback
Define what happens if a workload doesn’t perform as expected. Know how you’ll revert, how long it will take, and what data could be affected.

The important part is that these aren’t just questions for the vendor. Run the tests yourself.

Conclusion

Moving from VMware to Sangfor HCI changes more than the hypervisor. It changes how you manage infrastructure, plan licensing costs, and support the environment after migration.

The migration itself is only part of the decision. The right partner matters too.

DC Technologies is a Sangfor Gold Partner, handling the migration, UAE-resident infrastructure, and ongoing support.

If your VMware renewal is forcing the decision, start by mapping your current environment and comparing the full cost of switching.

FAQs

Sangfor HCI combines virtualization, storage, networking, and security in one platform. It replaces VMware’s ESXi, vSAN, and NSX with aSV, aSAN, aNET, and aSEC.

It depends on hardware, support, training, and migration costs, not just licensing. Sangfor offers perpetual or subscription pricing, with costs agreed upfront.

Migration is planned in stages to minimize disruption. Some workloads may still require planned downtime.

Not extensive retraining. The core concepts stay the same, but your team will need time to get familiar with the new interface.

Don’t assume they will work unchanged. Backup and recovery should be tested on the new platform before migration is complete.
